ORR METRO
AIRPORT METRO
MISC
Bid Award : May 2021
|
Work Commencement : June 2021
|
Revised Deadline : December 2026
Piers
100%
Normal Piers100%
Portal Piers100%
Split Portal Piers100%
Caps/Beams
99%
+0%
Pier Caps100%
Portal Beams97%
Split Portal Tiebeams100%
Girders
98%
+1%
U Girder Spans100%
I-Girder Spans94%
Steel Girder Spans72%
HIGHLIGHTS:

  • SNC completeds launching all U Girders in their scope, making the big milestone.
  • Roof truss erection work begins at Doddanekundi Station.

DECEMBER

2025

Progress In The Month

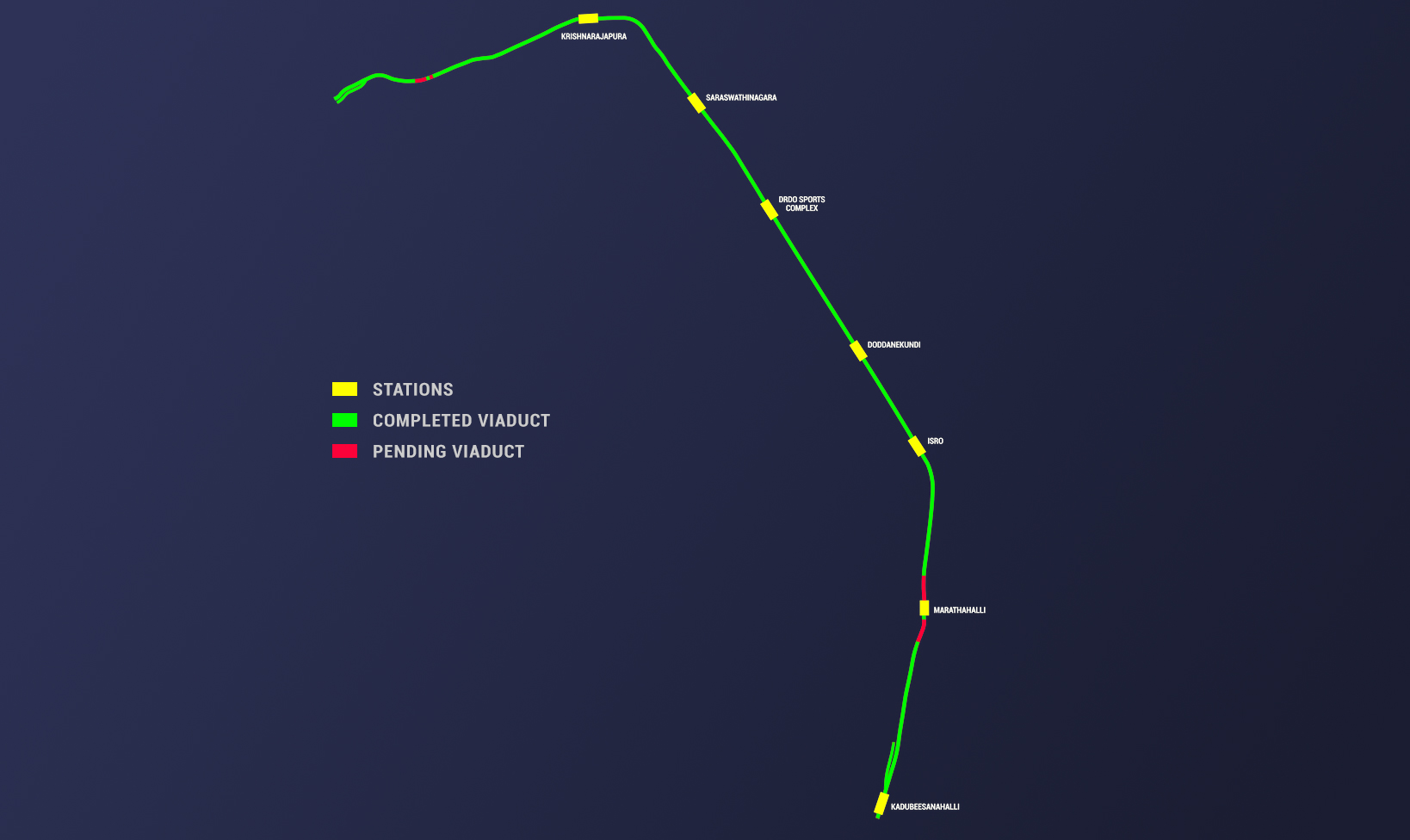

U & I Girders Progress In Last 6 Months
NOTE ON STATION'S PROGRESS:
    • ALL PUBLICLY TRACKABLE STATION'S PROGRESS ARE COMPLETED. REMAINING STATION WORK LIKE SECONDARY WING PIERS ON SERVICE ROAD MEDIAN, SECONDARY WING CAPS, CONCOURSE SLAB, PLATFORM SLAB, SECONDARY WING SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC CONTINUES. THESE WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.
  • Girders Progress
    Girders Progress
    Gallery Image 1

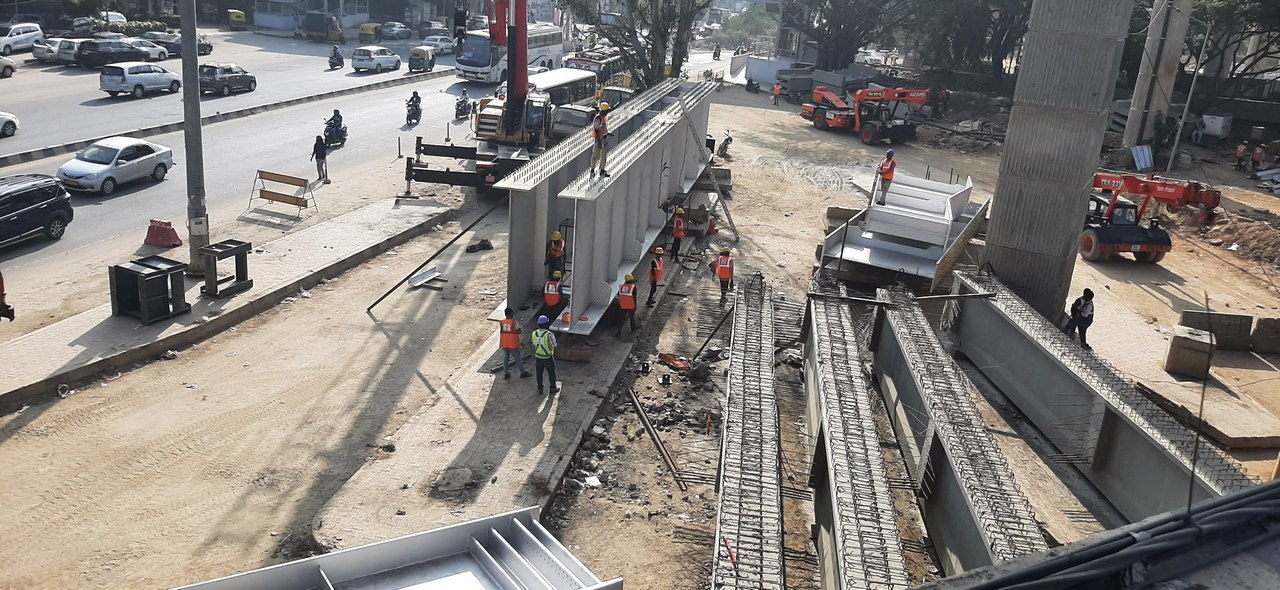

    Steel Parts For Span Near Benniganahalli Flyover

    © Photo Copyright: Sunil
    Gallery Image 2

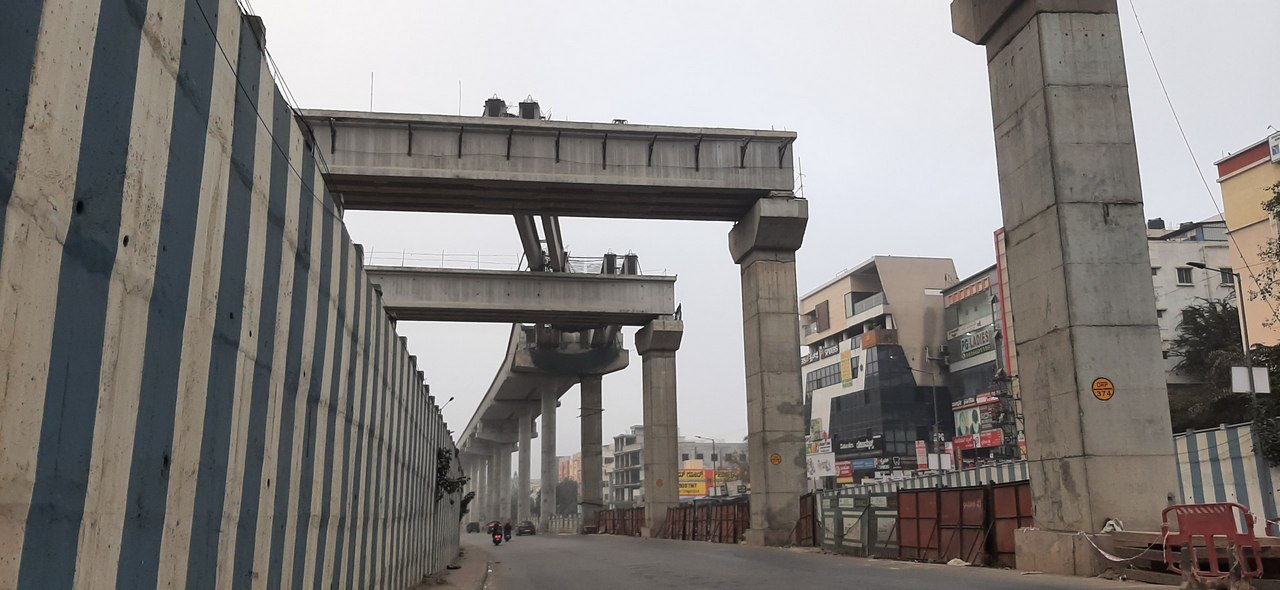

    Newly Launched I-Girders At Marathahalli Underpass

    © Photo Copyright: Sunil
    Gallery Image 3

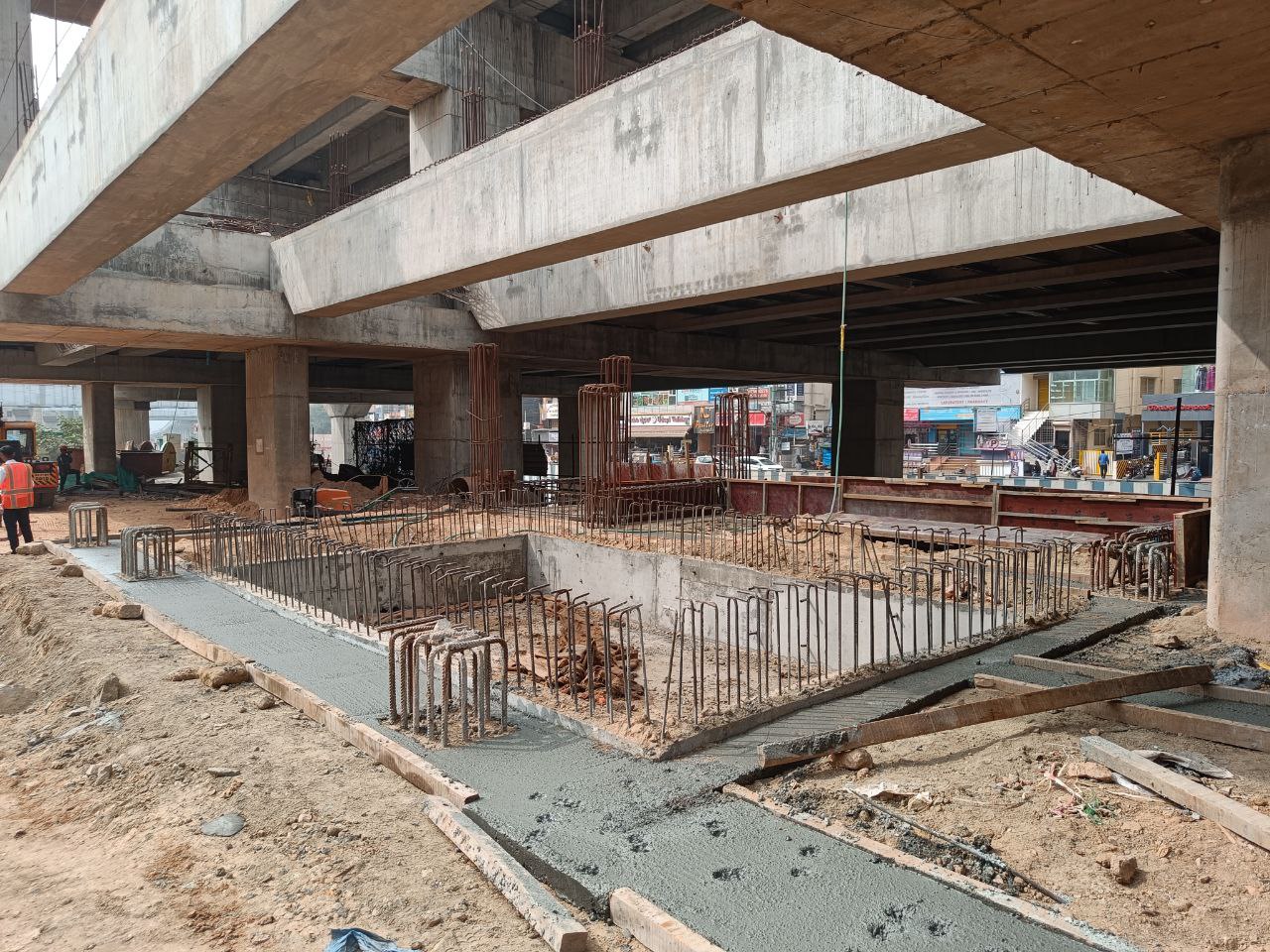

    Marathahalli Station Entrance Structure Work

    © Photo Copyright: Aditya
    Video Of Progress As Of December 14th 2025: By Sunil
