Launching / Casting of all mainline Pier Caps completed.
JANUARY
2026
ISSUES:

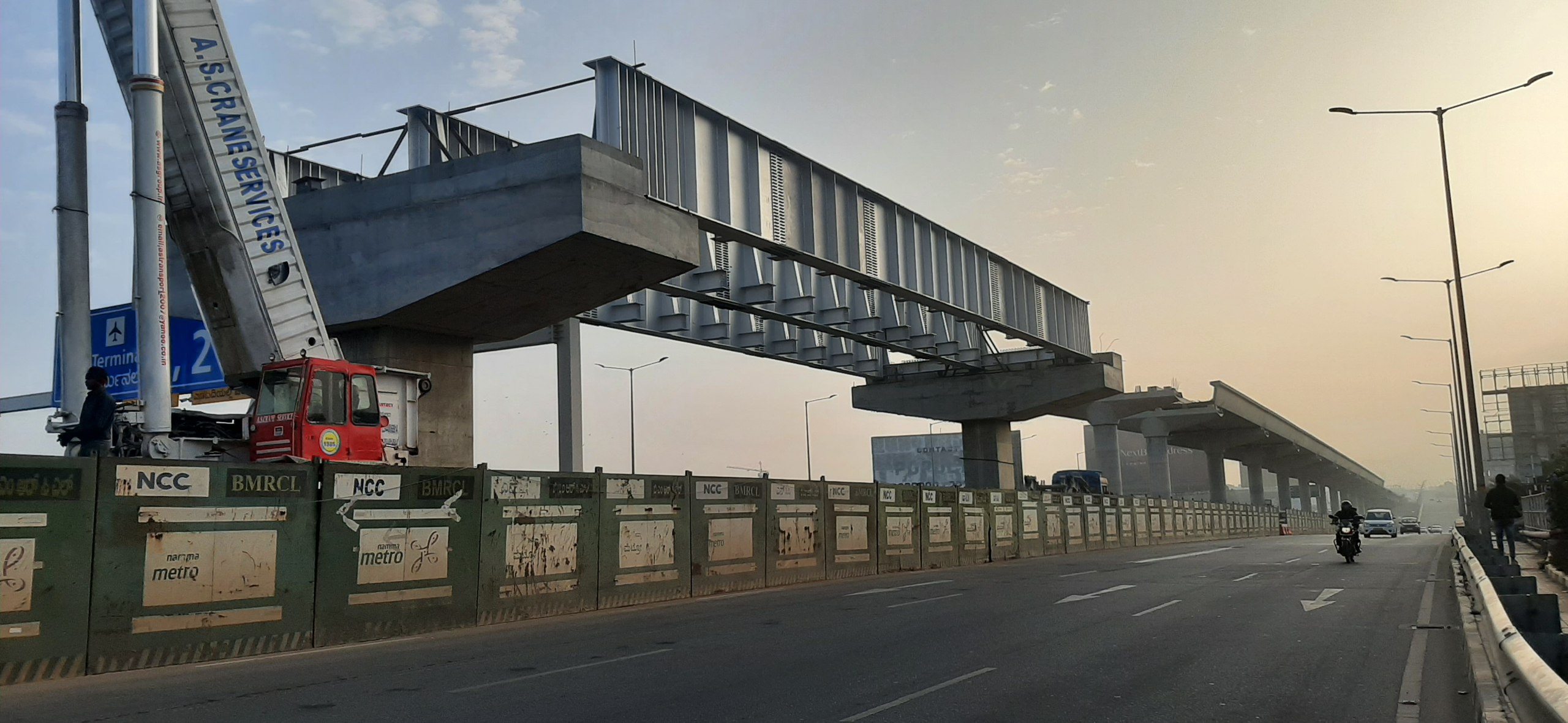

Delay in launching Portal Beams at MAR i.e., AP1053, AP1054, AP1055, AP1056.

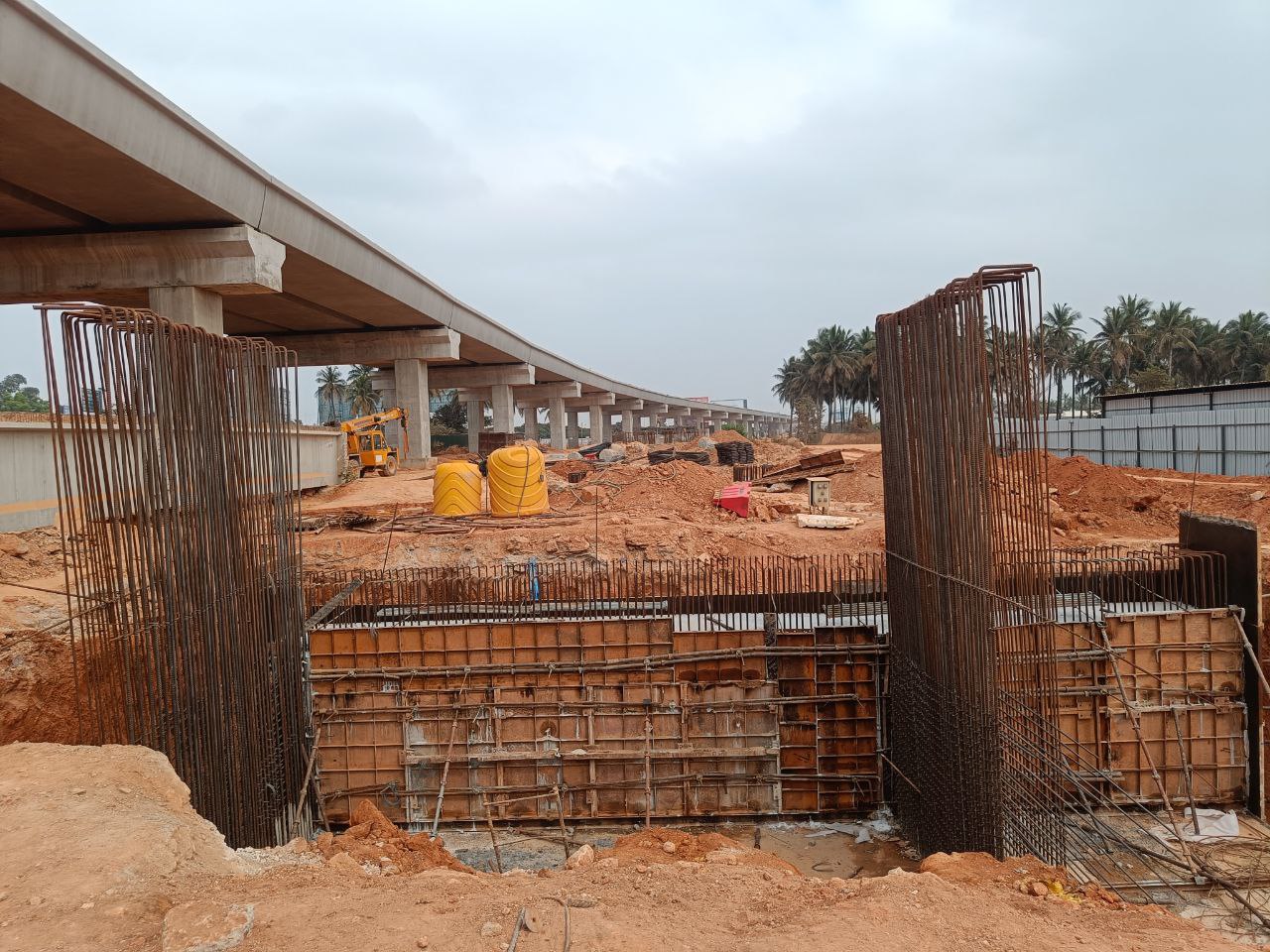

Delays in Viaduct completion between AP1035 to AP1057.

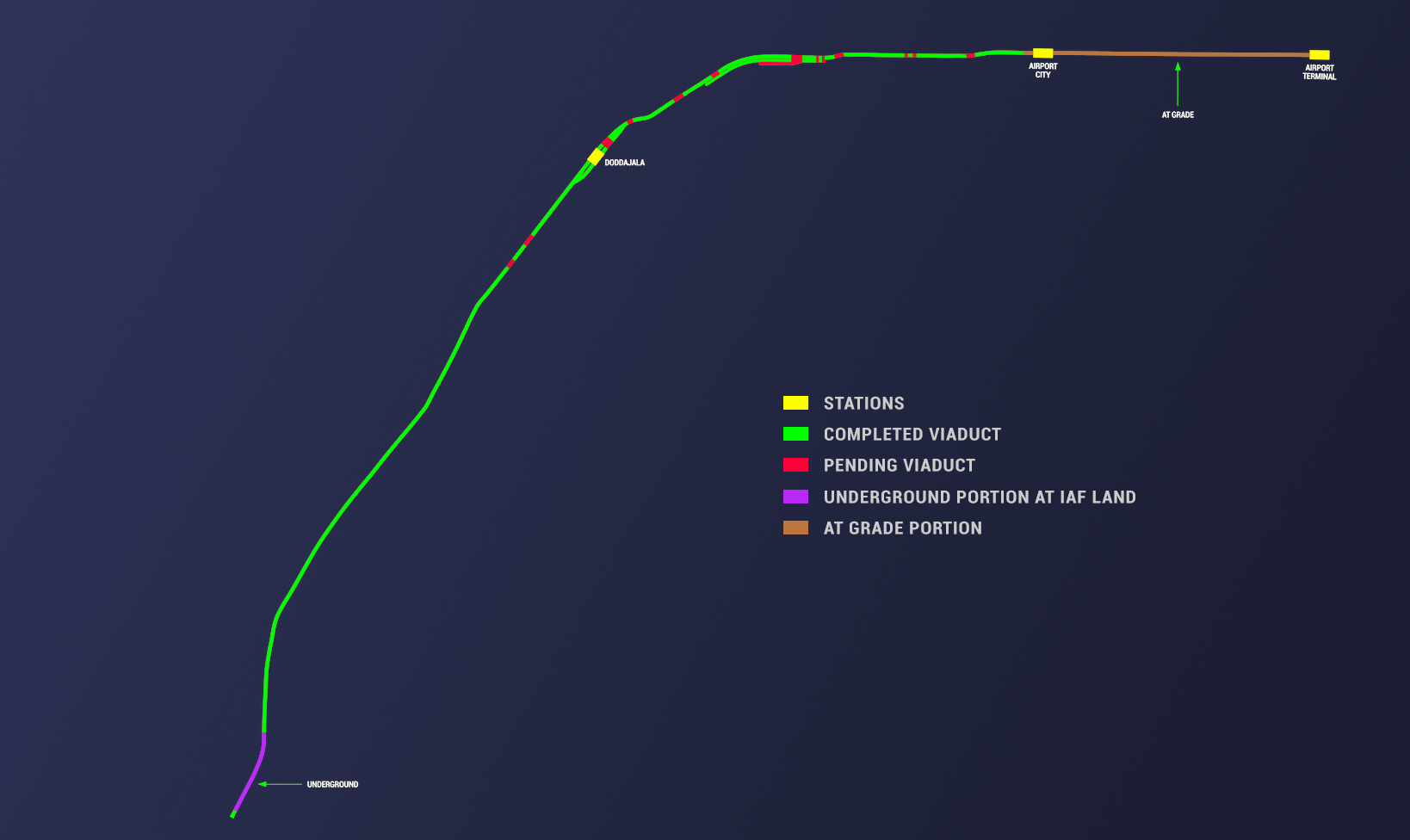

Progress In The Month
U Girders Progress In Last 6 Months
NOTE ON STATION'S PROGRESS:
ALL PUBLICLY TRACKABLE STATION'S PROGRESS ARE COMPLETED. REMAINING STATION WORK LIKE CONCOURSE SLAB, PLATFORM SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC CONTINUES. THESE WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.
