ORR METRO
AIRPORT METRO
MISC
Bid Award : November 2021
|
Work Commencement : February 2022
|
Revised Deadline : June 2027
Piers
95%
+2%
Normal Piers97%
Portal Piers88%
Caps/Beams
80%
+2%
Pier Caps83%
Portal Beams58%
Girders
69%
+3%
U Girder Spans74%
I-Girder Spans41%
Steel Girder Spans28%
Open Web Girder0%
HIGHLIGHTS:

  • Launching of all Girders at Yelahanka Pocket Track completed.

JANUARY

2026

ISSUES:

  • FOB near Palanahalli Road is obstructing the span AP669-AP671. Parts of composite girder is already at site. Approval for Height modifications of FOB is still pending. This is causing delays in span completion.
  • Site handover to contractor is still pending for 5 portal piers at Hebbal between AP365 to AP369.
  • Continuous changes in scope and delays in release of designs is delaying the project

Progress In The Month
U Girders Progress In Last 6 Months
STATIONS PROGRESS
Select Station:
DESCRIPTIONTOTALCOMPLETEDCOMPLETION
Piers GL To PD
1616
PDL Beams
84
Piers PD To CL
164
CCL Beams
80
Piers PD To TL
160
PFL Beams
80
CCL RCC/I-Girders
710
DFL RCC/I-Girders
700
PFL RCC/I-Girders
500
U Girders
140
NOTE ON STATION'S PROGRESS TABLE:
    • STATION'S PROGRESS BEING REPORTED CONSISTS ONLY OF MAIN GRID IN MEDIAN. OTHER THAN THIS, SECONDARY WING PIERS ON SERVICE ROAD MEDIAN, SECONDARY WING CAPS, GIRDERS, CONCOURSE SLAB, PLATFORM SLAB, SECONDARY WING SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.

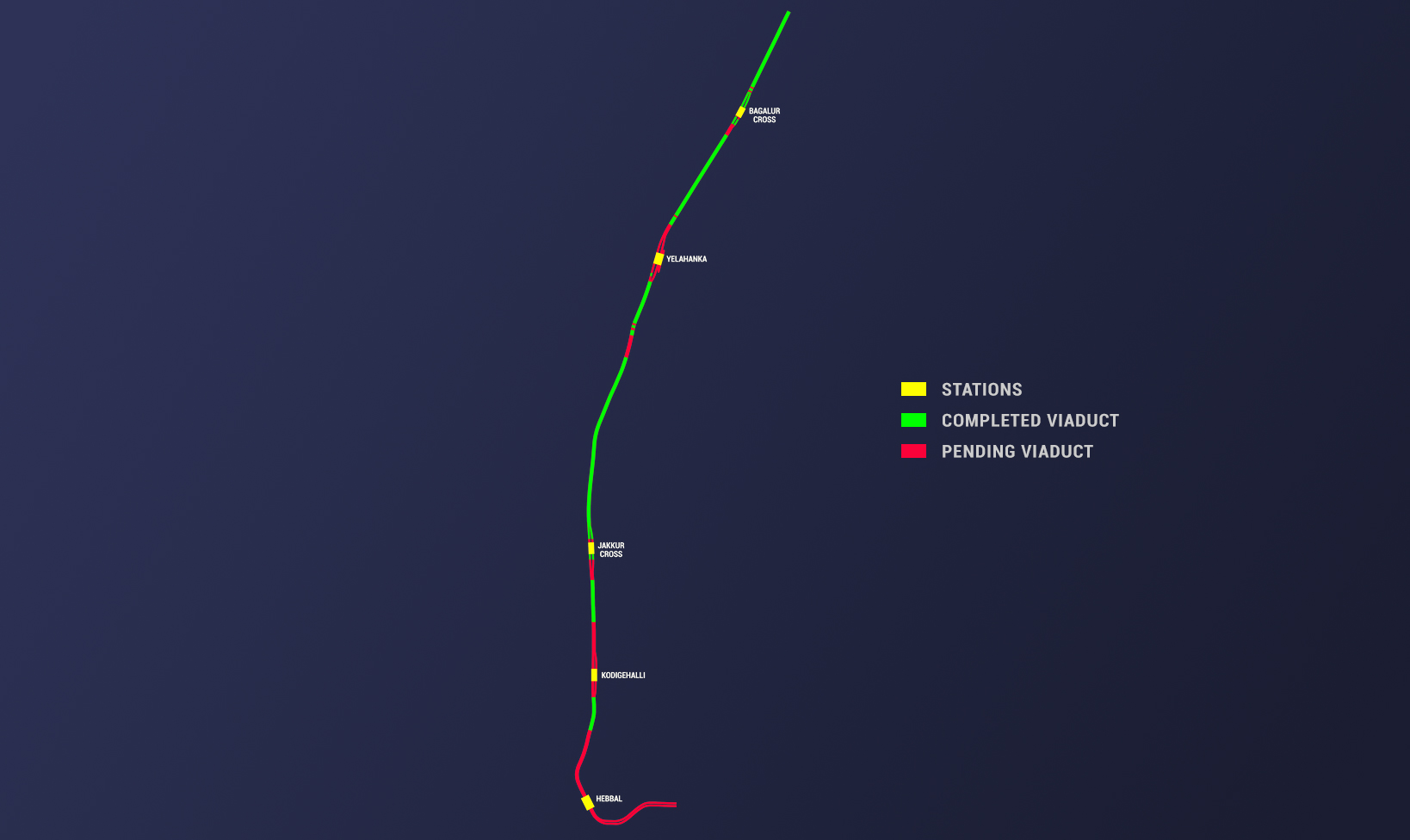

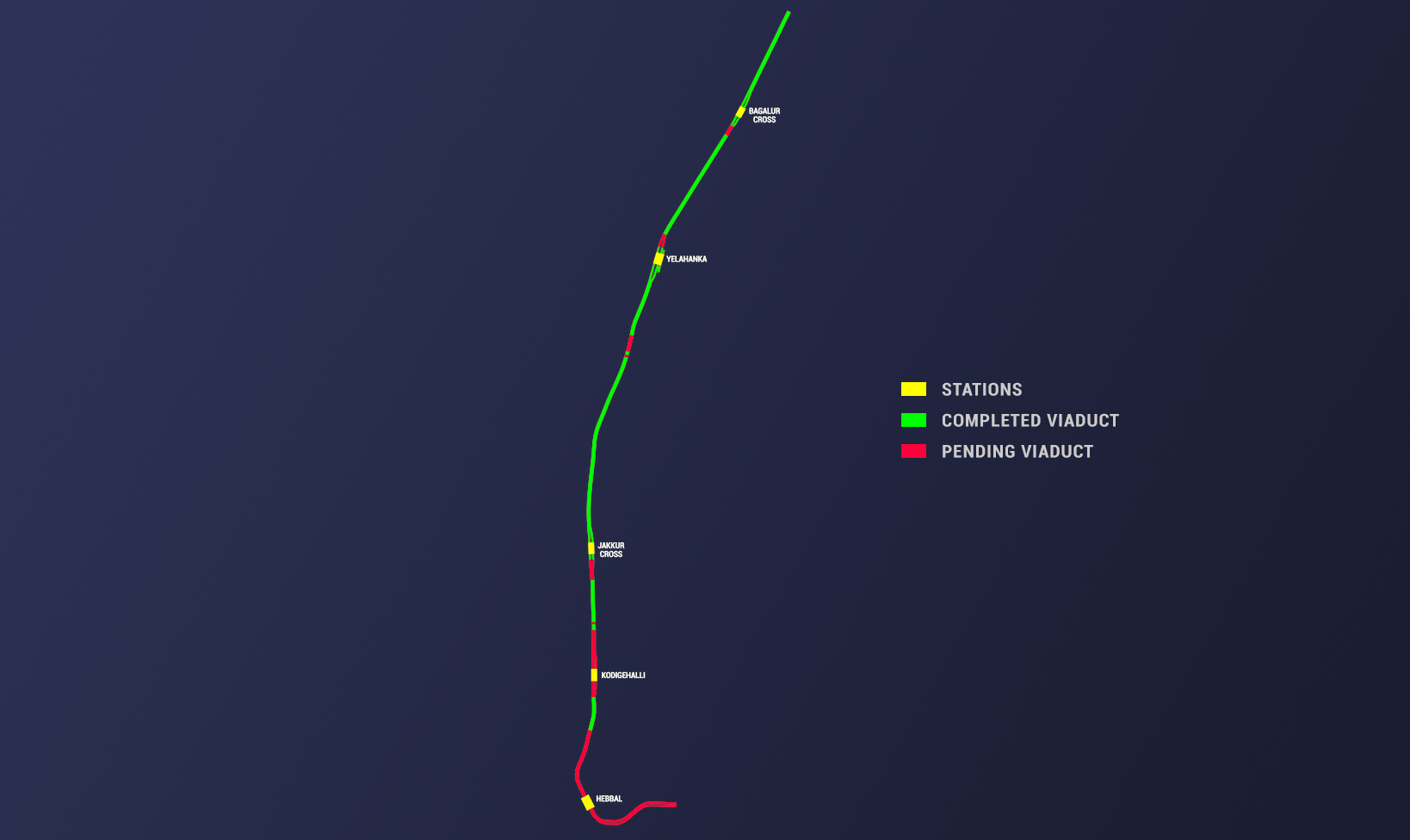

  • Girders Progress
    Girders Progress
    Gallery Image 1

    Entry/Exit Structure Works At Jakkur Cross Station

    Gallery Image 2

    Hebbal Station

    © Photo Copyright: Sunil
    Gallery Image 3

    Ongoing Roof Work At Bagaluru Cross Station

    Video Of Progress As Of January 8th 2025: By Sunil
