Launching of all Station Arms of Horamavu Station completed.
Launching of I-Girders of Kalyan Nagara Station main grid completed.
1st Platform Arm of Kasturinagara Station launched.
Casting of all piers of Kasturinagara Station upto track level completed.
Launching of Concourse Pier Caps of HBR Layout Station completed.
1st pier of HBR Layout Station cast upto track level.
JANUARY
2026
ISSUES:
No works happening at Nagawara Station since last 4 months. No works at Kempapura Station main grid too.
Delays in Pier works between HBR Layout Station to Veerannapalya. (AP226, AP227, AP229, AP236, AP237, AP238, AP239, AP256, AP258, AP259, AP267, AP274R, AP276L).
Delays in Pier works between Benniganahalli to Kasturinagara. (AP22-AP35)
Utility shifting pending at AP238R, near Nagawara Flyover.
Pace of work is slow in completion of Split Portal Piers (Hennur Underpass, Veerannapalya Flyover, Nagawara Flyover).
Continuous changes in scope and delays in release of designs is delaying the project.
Progress In The Month
U Girders Progress In Last 6 Months
STATIONS PROGRESS
Select Station:
DESCRIPTION
TOTAL
COMPLETED
COMPLETION
Piers GL To CL
8
8
CCL Pier Cap
8
8
Piers CL To TL
8
8
PFL Pier Cap
8
5
PFL Arms
16
2
CCL Arms
16
0
CCL RCC/I-Girder Spans
42
0
PFL RCC/I-Girder Spans
28
0
U Girders
14
0
NOTE ON STATION'S PROGRESS TABLE:
STATION'S PROGRESS BEING REPORTED CONSISTS ONLY OF MAIN GRID IN MEDIAN. OTHER THAN THIS, SECONDARY WING PIERS ON SERVICE ROAD MEDIAN, SECONDARY WING CAPS, GIRDERS, CONCOURSE SLAB, PLATFORM SLAB, SECONDARY WING SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.

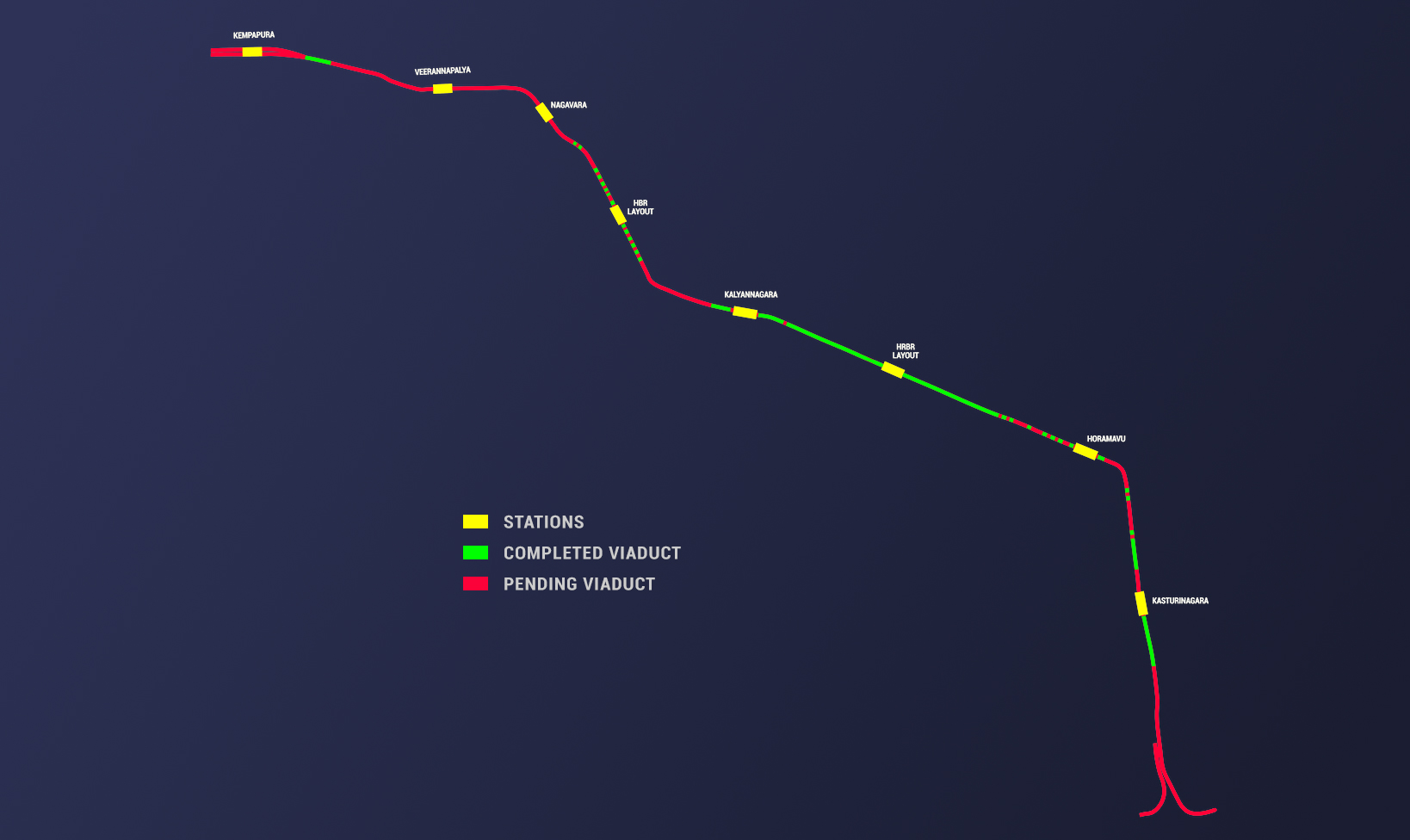

Girders Progress

HRBR Layout Station Entry/Exit Structure Works

LG Being Dismantled At Babusapalya

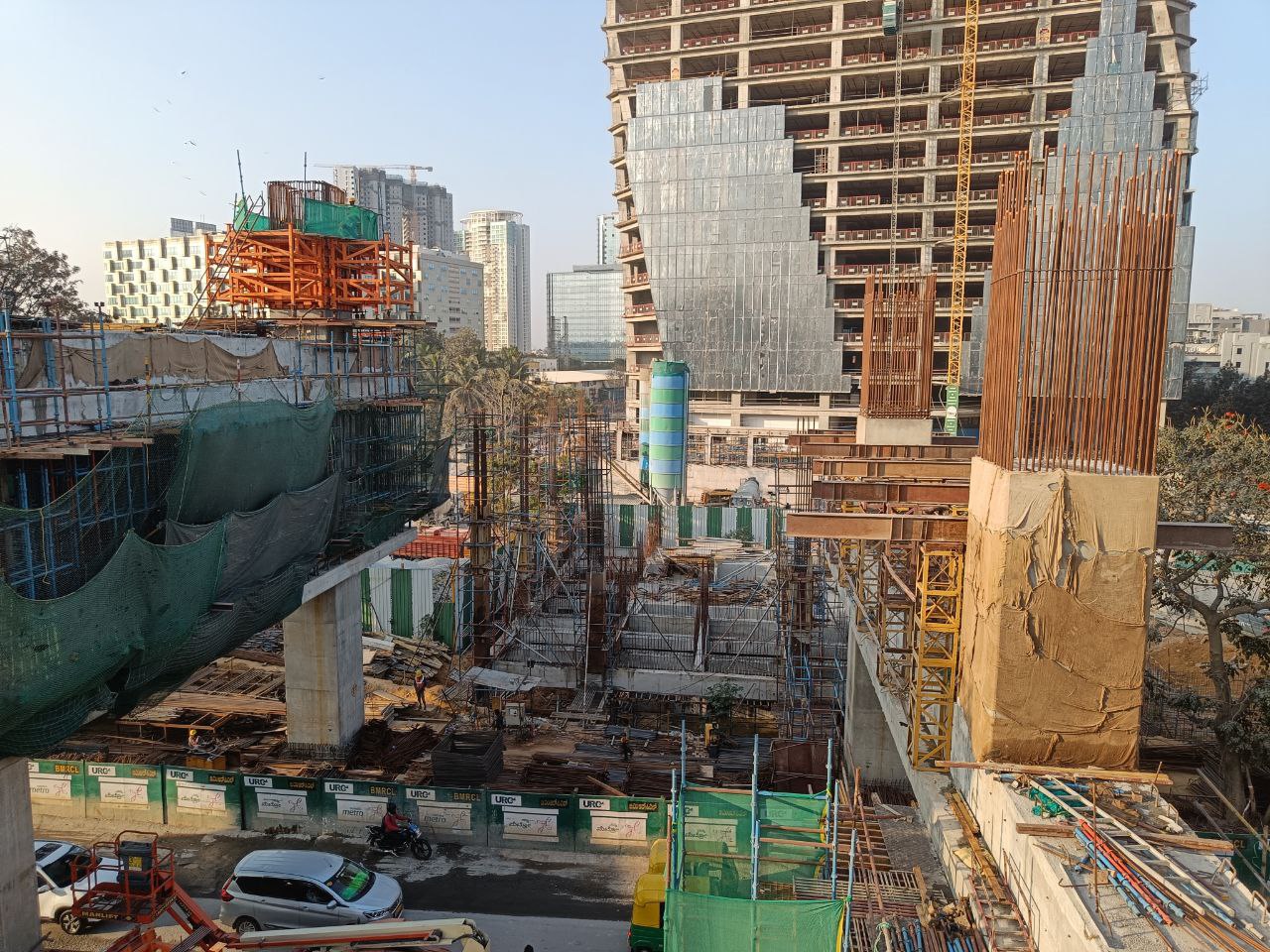

Veerannapalya Station
Video Of Progress As Of January 11th 2025: By Sunil
