Launching of all Girders of Silkboard Flyover completed.
Launching of all Secondary Pier Caps across all Stations completed.
Clearing of concrete foundation at Bellandur ongoing, upon which Gantry Crane was assembled.
Site access finally granted at Silkboard for final pier - ORP13.
Work resumes at Portals of Silkboard reversal track.
JANUARY
2026
ISSUES:
Work on RHS Entry/Exit Structures of HSR Layout Station stuck. No work since months.
No work on 1 Silkboard portal - ORP12 - since months.
Slow pace of works at Silkboard Station entrance structure.
Progress In The Month
U & I Girders Progress In Last 6 Months
STATIONS PROGRESS
Select Station:
DESCRIPTION
TOTAL
COMPLETED
COMPLETION
Piers GL To CCL
9
9
CCL Pier Cap
9
9
Piers CL To TL
9
9
PFL Pier Cap
8
8
PFL Arms
17
16
CCL Arms
18
18
CCL RCC/I-Girders
64
56
PFL RCC/I-Girders
48
42
U Girders
14
14
NOTE ON STATION'S PROGRESS TABLE:
STATION'S PROGRESS BEING REPORTED CONSISTS ONLY OF MAIN GRID IN MEDIAN. OTHER THAN THIS, SECONDARY WING PIERS ON SERVICE ROAD MEDIAN, SECONDARY WING CAPS, GIRDERS, CONCOURSE SLAB, PLATFORM SLAB, SECONDARY WING SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.
SILKBOARD FLYOVER PROGRESS
DESCRIPTION
RAMP D
TOTAL
COMPLETED
Piers
38
38
Pier Caps
32
32
Portal Beams
3
3
I Girder Spans
28
28
Steel Girder Spans
6
6

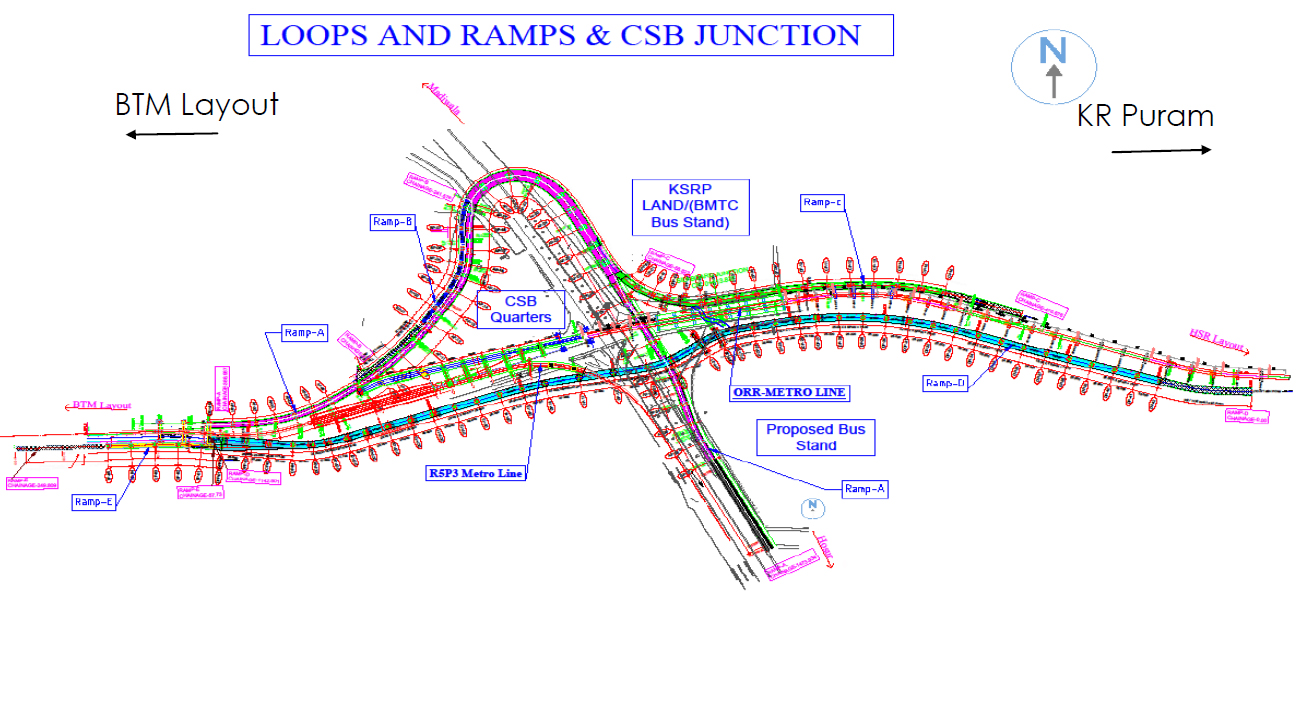

Silkboard Flyover Map

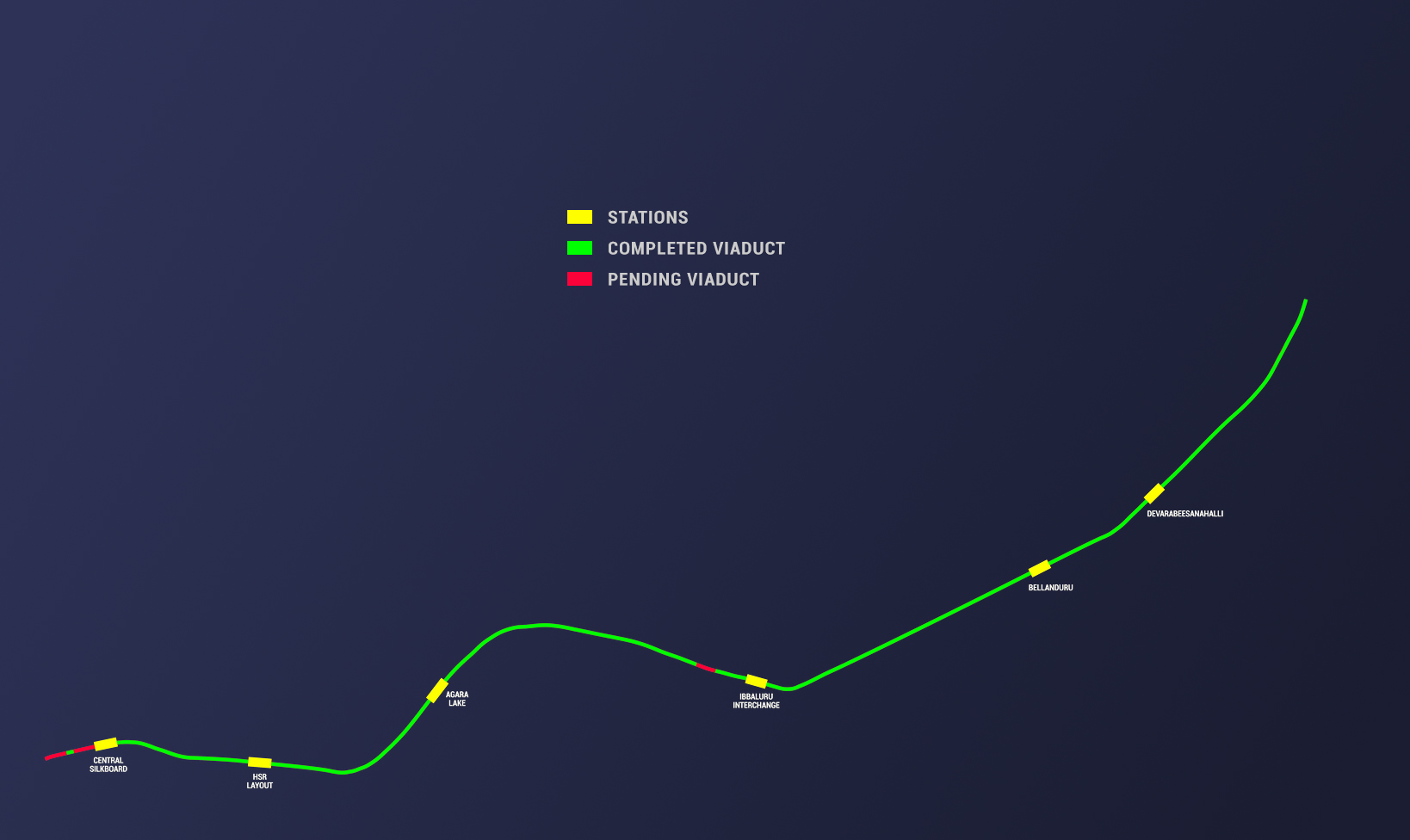

Girders Progress

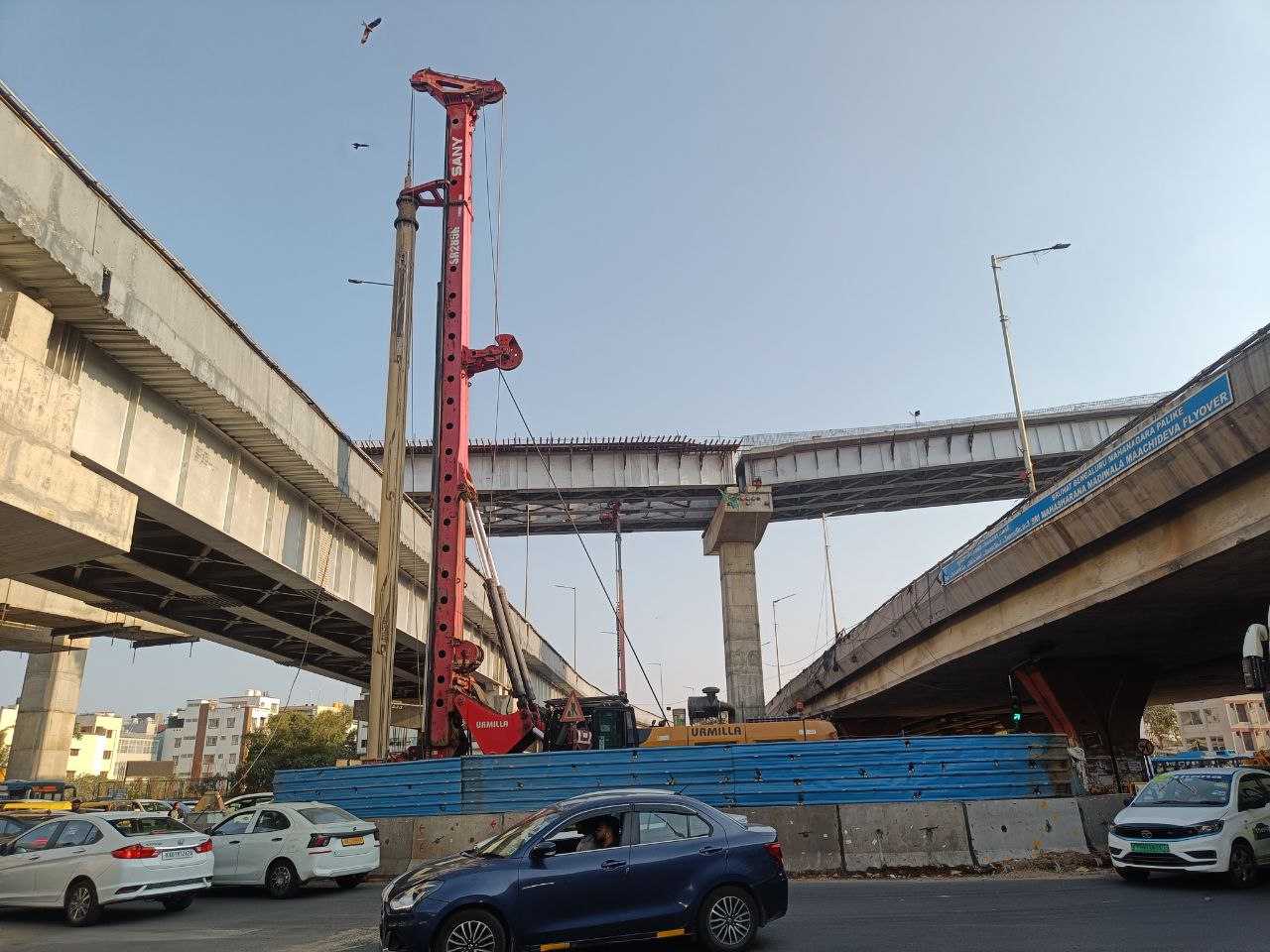

Work Commences On Final Pier At Silkboard

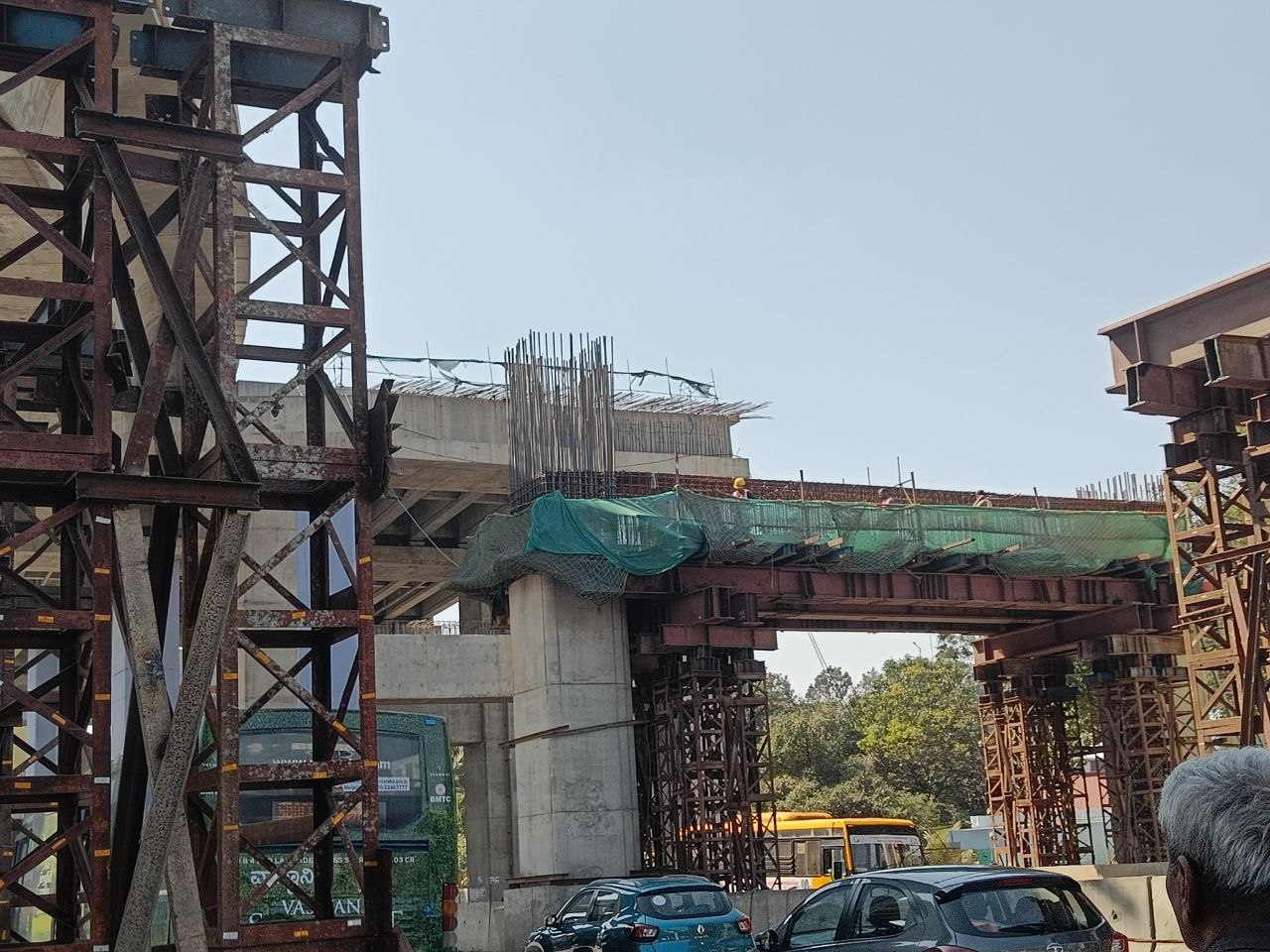

Work Resumes At Silkboard Portals

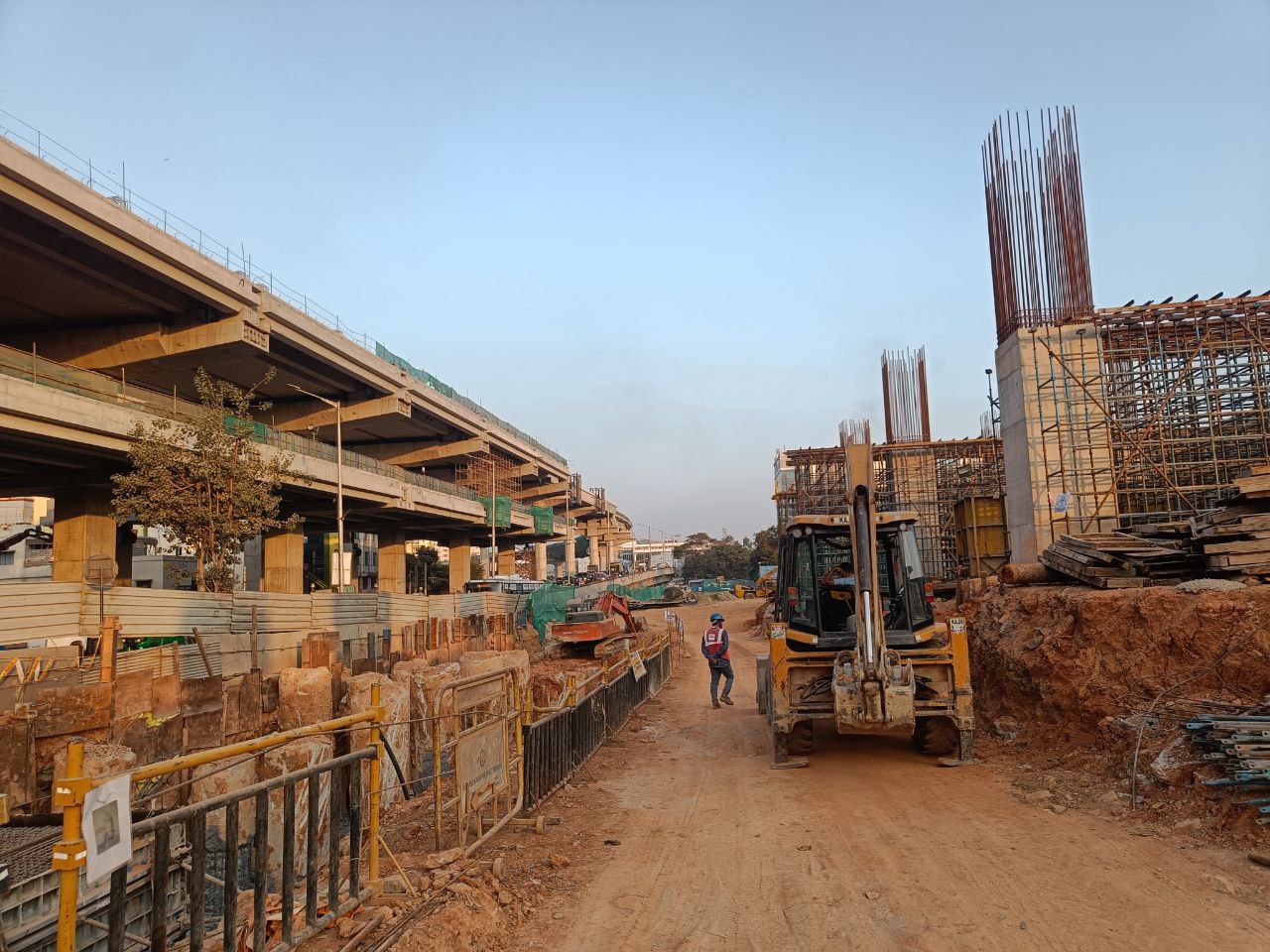

Ibbaluru Red Line Station
Video Of Progress As Of January 11th 2025: By Sunil
